Why soil testing in Houston is different
Most of the Houston metro is built on the Beaumont Formation and related Pleistocene deposits: fat clays with liquid limits above 50 and plasticity indexes that routinely exceed 30. These clays take on water and swell, then dry and shrink, and the seasonal movement at the surface can exceed several inches. Every cracked driveway and every out-of-level foundation in Fort Bend and Harris County has that mechanism somewhere in its history.
Soil testing on a Houston project is therefore mostly about three questions. How expansive is the native soil under the building, and what foundation does that call for? Is the fill placed under the slab the low-plasticity material the specification requires, or did clay from the site excavation end up in it? And was that fill compacted at the moisture content and density the design assumed, lift by lift, before the slab went down? The tests below are how those questions get answered with numbers instead of opinions.
Two services with the same name
The first is the geotechnical investigation, which happens before design. A drill rig puts borings down through the building footprint, typically 20 to 40 feet for a commercial slab and deeper for structures on piers, samples are recovered, and a laboratory runs classification and swell-related tests on them. The geotechnical engineer's report then recommends the foundation type, the bearing values, the select fill depth, and the potential vertical rise the structure must tolerate. That report is what the structural engineer designs from.
The second is construction materials testing during earthwork, which happens after the geotechnical report and before and during the slab. Here the questions are narrower: does the fill meet the specification, and is it compacted. The technician is on site with a nuclear gauge, samples go to the laboratory for Proctors and index tests, and every lift is either accepted or reworked. This is the service a contractor or owner is usually asking about when they search for soil testing during construction.
The two services use overlapping tests but serve different decisions, and the same agency can provide both. What matters is that the construction-phase testing is done against the geotechnical report's actual recommendations, which means the technician needs a copy of it.
The tests that qualify a fill source
Before select fill is hauled in, a sample from the borrow source is tested to prove it meets the specification. The two controlling tests are gradation and plasticity. A sieve analysis per ASTM D6913, with the fines determined by washing per ASTM D1140, establishes how much of the material passes the No. 200 sieve; Houston-area select fill specifications commonly allow 15 to 35 percent fines. The Atterberg limits per ASTM D4318 establish the liquid limit and plasticity index of those fines, and a typical specification caps the PI between 12 and 20 so the fill cannot swell the way the native clay does.

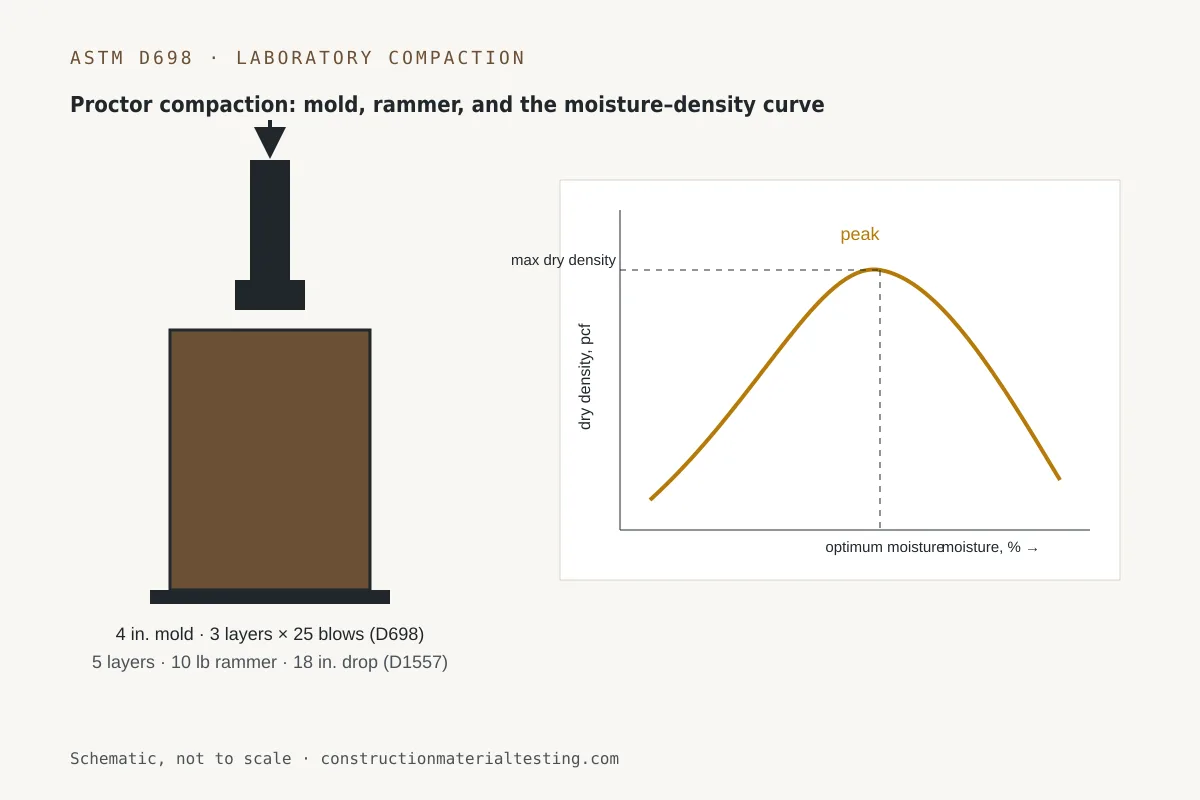

Together those results classify the material under the Unified Soil Classification System, ASTM D2487, and the classification is what the specification usually names: a clayey sand or sandy lean clay is acceptable, a fat clay is not. A moisture-density relationship, the Proctor curve, is run on the same sample per ASTM D698 or D1557 depending on the specification, and it produces the maximum dry density and optimum moisture content that field compaction will be judged against. If the fill contains significant gravel, the curve is corrected for oversize per ASTM D4718.
A source qualification package, meaning gradation, Atterberg limits, classification, and Proctor, is typically one to two working days in the laboratory. It is worth doing before the first truck moves, because rejecting a fill source after 2,000 cubic yards are on site is a conversation nobody enjoys.
The tests that verify compaction, lift by lift
Once fill is placed and compacted, a technician measures its in-place density and moisture content with a nuclear gauge per ASTM D6938. The gauge reading is compared to the Proctor maximum, and the result is a percentage: the specification will require 95 percent of standard Proctor, or 98 percent under a slab, or 95 percent of modified Proctor for pavements, at a moisture content within a stated range of optimum, often minus 2 to plus 3 percentage points.
The moisture range is not a formality on Houston clays. Fill compacted dry of optimum can look dense and still swell later when it takes on water; fill placed wet of optimum pumps under the roller and never reaches density. Specifications for expansive soils are written to compact slightly wet of optimum for exactly that reason, and the technician's job is to enforce the moisture window as strictly as the density number.
Test frequency is set by the specification, commonly one test per lift per 2,500 to 5,000 square feet of building pad, and one per 100 linear feet of utility trench backfill. A technician on a building pad runs the gauge, records the result, and either signs off the lift or tells the contractor to add water, dry it out, or roll it again. Failed tests are retested after rework. The daily field report lists every test location, elevation, result, and disposition, and that report is what the engineer and the building official rely on when the slab is poured.
Laboratory tests you may also see on a Houston project
Moisture content per ASTM D2216 appears on nearly every report because it is the basis for every dry-density calculation. Specific gravity per ASTM D854 shows up in geotechnical reports for phase calculations. Hydrometer analysis per ASTM D7928 gives the clay-size fraction used with the plasticity index to estimate swell potential. Lime-stabilized subgrade, which is common under Houston pavements and some pads, adds its own set: pH for lime demand, pulverization gradation, and depth checks on the treated layer.
Soil corrosivity testing, pH per ASTM G51 and resistivity per ASTM G57 or G187, is required for mechanically stabilized earth walls, buried pipelines, and some foundation work. It is unrelated to compaction and is often specified by the wall or pipe manufacturer rather than the geotechnical engineer, so it can be missed until submittal review.
How soil testing is scheduled and what it costs
Construction-phase density testing is billed by technician hour, with a minimum per visit, and a Houston-metro project can usually schedule same-day or next-morning for a pad or trench. Laboratory tests are billed per sample: a Proctor, a set of Atterberg limits, a gradation, and a moisture content each carry a unit price. A full fill-source qualification is a few hundred dollars; a technician day on a building pad is priced by the hour and is typically the larger line item on a project because there are many lifts.
A geotechnical investigation is priced by the boring: rig mobilization, footage drilled, sampling, laboratory testing, and engineering. A small commercial site with three or four borings is a few thousand dollars and two to four weeks from authorization to report, most of that being laboratory time and engineering review. Trying to skip it, or to design from a neighbor's report, is the most expensive money a Houston project can save.
For a project with defined plans, the right way to price all of it is a written proposal from the specification: the fill quantities, the pad area, the lift count, and the required frequencies give a defensible total. Send the plans, or the geotechnical report, and the number can be worked out before the first day of earthwork.
Common questions about soil testing in Houston
What is a Proctor test and why does the contractor keep asking for it?
The Proctor, ASTM D698 or D1557, establishes the maximum density a specific soil can reach at its optimum moisture content. Field density tests are meaningless without it, and every new fill source needs its own curve.
Can we use the soil we dug out of the site as fill?
Under a slab in the Houston area, usually not — native clay fails the plasticity limit. It is often acceptable for landscape berms or non-structural fill, and the specification will say where.
How deep do the borings need to be?
The geotechnical engineer decides based on the structure. A rule of thumb for slab-on-grade commercial work in this area is 20 feet minimum, deeper where piers or heavy loads are anticipated, because the active zone of moisture change in Houston clays extends well below the surface.
What happens if a density test fails?
The lift is reworked, meaning moisture is adjusted and the area is recompacted, and it is retested before the next lift goes on. A failed test that is not retested and passed is a gap in the record that will surface at the pre-pour inspection.
